acequia rehabilitation

Acequia rehabilitation

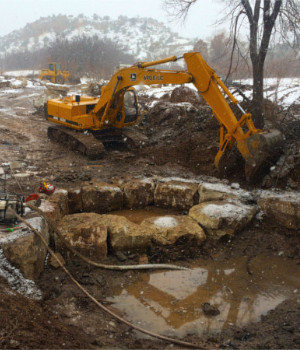

STORM DITCH ASSOCIATION DIVERSION DAM & DISCHARGE AREA REHABILITATION:

Contractor: Apple Mountain Constructors, LLC

Contract Amount: $380,230.65

Project Completion Date: June 21, 2018

The Work under the Contract Documents may be generally described as follows:

The Work consists of earthwork and removal of vegetation for the rehabilitation of the diversion structure including the installation of four (4) boulder cross vane structures with rock cutoff sills on the Rio Ruidoso, a 50 linear foot rock wall, a new steel irrigation heading structure with 30” diameter headgates, and installation of 60 linear feet of 30” diameter corrugated metal pipe. The restoration of the diversion dam project area shall include final grading to the specified elevations and side slopes, transplanting of excavated vegetation, stabilization of designated areas, and native plantings along the riparian zone.

The Discharge Area Work consists of stabilization of the existing channel providing return flow to the Rio Bonito with boulder structures including two (2) plunge pools and +/- 81 linear feet of rock step structures.

Acequia rehabilitation

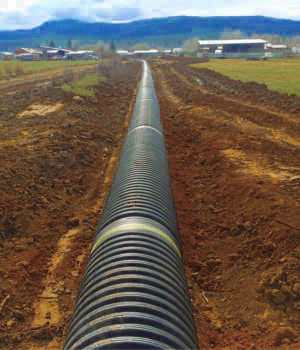

ENSEÑADA ACEQUIA REHABILITATION:

Contractor: Century Club Construction

Contract Amount: $59,999.00

Project Completion Date: May 04, 2015

The work consisted of clearing and grubbing, the preparation of subgrade, and the placement of approximately 537 ft. of 36" High Density Polyethylene Pipe and fittings, backfill.

new mexico civil engineering

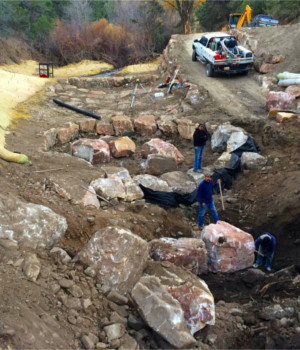

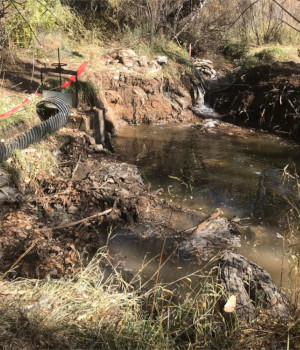

TALPA RESERVOIR DITCH DIVERSION STRUCTURE REHABILITATION:

Contractor: Barney & Son Excavating

Contract Amount: $99,228.90

Project Completion Date: November 17, 2014

The work consisted of the rehabilitation of the existing diversion structure by the installation of boulder step pool structures, a grade control structure, and rock walls. A new irrigation heading structure and 24" dia. headgates were fabricated from steel. Restoration of the project area included seeding and stabilization of disturbed areas with erosion control blanket, and willow livestake plantings along the river banks.

new mexico water resource consultants

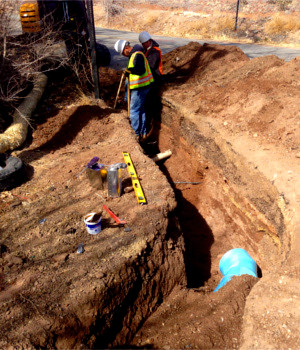

ACEQUIA DE LA CIEÑEGA:

Contractor: Desert Utility & Paving, LLC

Contract Amount: $87,276.40

Project Completion Date: April 29, 2013

The work consisted of the excavation of a trench, placement of up to 1,560 ft. of 12" PVC pipe including related fittings and valves, backfill, replacement of pavement and testing of the installed pipeline.

civil engineers

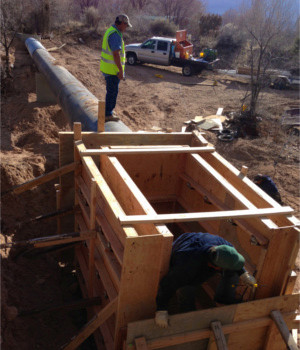

ACEQUIA DE LA CAÑADA ANCHA:

Contractor: Allied 360 Construction

Contract Amount: $36,658.30

Project Completion Date: April 24, 2013

The work consisted of the removal of a 36" CMP siphon and concrete intake and outfall structures. Work included the construction of an arroyo crossing consisting of 45 feet of 36" CMP, 54 ft. of 36" steel pipe, reinforced concrete abutments, intake and outfall structures.

Water Resource Consultant

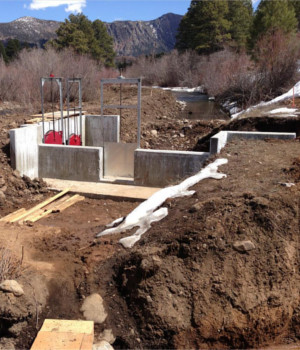

RIO BRAZOS ACEQUIA WATER CONTROL PROJECT:

Contrator: CJ Mead Construction Co., Inc.

Contract Amount: $109,705.36

Project Completion Date: August 7, 2013

The work consisted of clearing and grubbing, erosion and sediment control, construction of a reinforced concrete irrigation heading structure, gate installation, CMP and metal work, placement of compacted earthfill, water control and distribution during construction and site restoration.

Civil Engineer

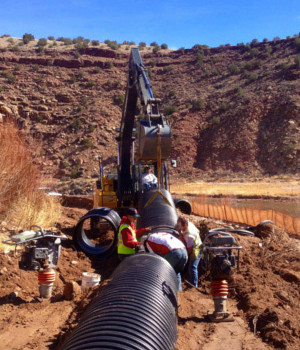

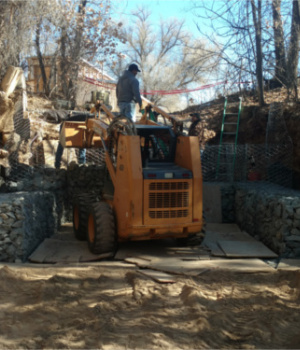

ABEYTA-TRUJILLO ACEQUIA IMPROVEMENT:

Contractor: Blueline Construction

Contract Amount: $112,885.75

Project Completion Date: April 20, 2012

The work consisted of clearing and grubbing, the preparation of subgrade, and the placement of approximately 1,245 ft of 36” of Corrugated Polyethylene Pipe including pipe intake, sluice, and outfall structures.

Ditch Rehabilitation

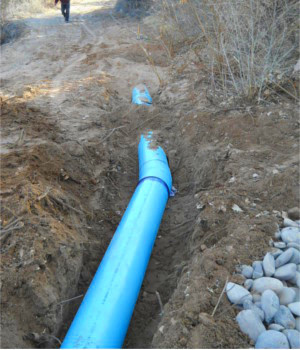

EL BARRANCO COMMUNITY DITCH PIPELINE:

Contractor: Randy Sena Construction, Inc.

Contract Amount: $29,342.52

Project Completion Date: February 17, 2012

The work consisted of the excavation and placement of approximately 847 ft of 12” SDR 51 PVC Pipe, backfill, and site restoration.

Canal Improvements

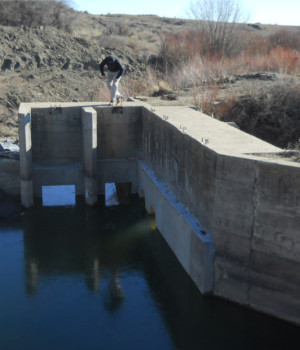

CS CANAL IMPROVEMENTS

Contractor: R. Minnix Construction, Inc.

Contract Amount: $125,626.00

Project Completion Date: April 18, 2012

The work consisted of the furnishing of all labor, material, transportation, tools, supplies, equipment, and appurtenaces necessary to control surface and ground water to rehabilitate the CS canal heading, excavate and remove sediment from river channel, excavate earth and placement of backfill, demolish and remove existing turnouts, install corrugated pipe, install reinforced concrete wier, furnish and install water control gates and installation of rip rap.
